Photo: May 5, 2026
Permit and rebuild status
Jasper National Park
This page provides current information on development and building permit activity at the Jasper Development Office. Here, you’ll find:
- Community rebuild progress information in the Municipality of Jasper
- Current average permit processing timelines
- Volume of applications received
- The number of permits at each stage of the review process
- Historical data (permits issued since September 2024 – present)

Detailed information on overall numbers for both fire impacted and non-fire impacted projects for all of Jasper National Park (within the Municipality of Jasper and outside the townsite) is also available on this page.
Information is updated regularly to offer a clear view of recovery progress, processing trends, and current volume of applications.
Community rebuild progress information in the Municipality of Jasper (Updated June 8, 2026)
Rebuild progress is moving forward in Jasper, as construction starts are continuing to increase across town. Each new construction start marks a meaningful step towards the overall recovery of the community.
Site preparation status of fire-impacted properties within the Municipality of Jasper
Text version

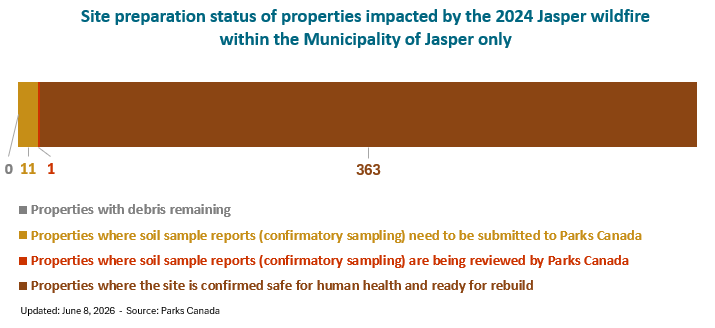

| Status | Number of properties |
|---|---|
|
Properties with debris remaining |
0 |
|
Properties where soil sample reports (confirmatory sampling) need to be submitted to Parks Canada |
11 |
|
Properties where soil sample reports (confirmatory sampling) are being reviewed by Parks Canada |
1 |
|
Properties where the site is confirmed safe for human health (Certificate of Completion from Parks Canada) |
363 |

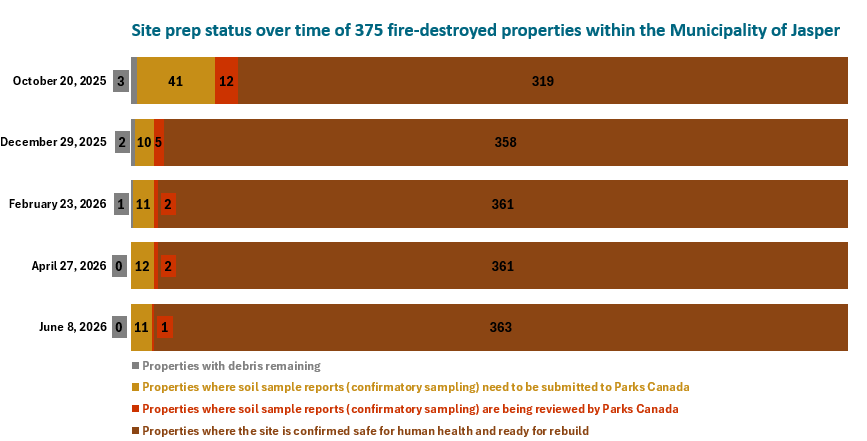

Site preparation status over time of 375 fire-impacted properties within the Municipality of Jasper
Text version
|
Status |
Number of properties | |||||
|---|---|---|---|---|---|---|
| October 20, 2025 | December 29, 2025 | February 23, 2026 | April 27, 2026 | June 8, 2026 | ||
| Properties with debris remaining | 3 | 2 | 1 | 0 | 0 | |
| Properties where soil sample reports (confirmatory sampling) need to be submitted to Parks Canada | 41 | 10 | 11 | 12 | 11 | |
| Properties where soil sample reports (confirmatory sampling) are being reviewed by Parks Canada | 12 | 5 | 2 | 2 | 1 | |
| Properties where the site is confirmed safe for human health (Certificate of Completion from Parks Canada) | 319 | 358 | 361 | 361 | 363 | |
*The initial rapid assessment identified 358 destroyed structures immediately following the 2024 Jasper wildfire. Further assessment showed that remediation was required at 375 properties. Overall figures were updated on October 20, 2025, to reflect current recovery progress.
The total number of properties in the site preparation graphs are different from the rebuild graphs because one property required cleanup but did not lose a structure, so it does not need to be rebuilt.
Rebuild status of destroyed properties
The following presents the status of properties destroyed in the 2024 Jasper Wildfire as they move through the phases of rebuilding. Each property appears on the graphic only once. Projects in later phases have met all required criteria in earlier phases (for example, a project under construction or at the occupancy stage also has an approved building permit). We recognise that timelines for rebuilding will vary for individuals based on a variety of factors.
Rebuild status of fire-destroyed properties within the Municipality of Jasper
Updated: June 8, 2026 - Source: Parks Canada
Text version
| Status | Number of properties |
|---|---|
|
Phases 1 & 2: Prepare & design (properties with no permit applications)
|
132 |
|
Phase 3A: Application process (properties in the rebuild application process) |
82 |
|
Phase 3B: Building permit approved (properties ready for construction) |
40 |
|
Phase 4: Build (properties where construction is underway) |
87 |
|
Phase 5: Occupancy (properties with finished buildings) |
33 |
Rebuild status over time of 374 fire-destroyed properties within the Municipality of Jasper

Text version
|
Status |
Number of properties | |||||
|---|---|---|---|---|---|---|
| October 20, 2025 | December 29, 2025 | February 23, 2026 | April 27, 2026 | June 8, 2026 | ||
| Phases 1 & 2: Prepare & design (properties with no permit applications) | 229 | 202 | 179 | 151 | 132 | |
| Phase 3A: Application process (properties in the rebuild application process) | 70 | 65 | 78 | 82 | 82 | |
| Phase 3B: Building permit approved (properties ready for construction) | 39 | 30 | 28 | 43 | 40 | |
| Phase 4: Build (properties where construction is underway) | 32 | 66 | 74 | 77 | 87 | |
| Phase 5: Occupancy (properties with finished buildings) | 4 | 11 | 15 | 22 | 33 | |
*The initial rapid assessment identified 358 destroyed structures immediately following the 2024 Jasper wildfire. Based on further assessment it is anticipated that rebuilding is required at 374 properties. Estimated rebuild numbers were updated on October 20, 2025.
In addition to the 87 properties in Phase 4, an additional 31 properties have visible signs of construction work starting which are included in Phase 3B overall numbers.
More information on each rebuild phase is provided below. More supports will be added as they are identified and available.
Current development permit timelines
The following table provides information on current average timelines for development permit review. We have expanded our capacity and streamlined processes to reduce timelines. Timelines increase and decrease based on the amount of applications being received, among other factors. Information on average timelines will be updated regularly.
Current average timelines for development permits (number of days from permit submission to issuance in business days)
| Application category | April 28 to May 11, 2026 | May 12 to May 25, 2026 | May 26 to June 8, 2026 |
|---|---|---|---|
| Complete and conforming | 22 business days | 17 business days | 12 business days |
| Incomplete or minor non-conformance | 29 business days | 28 business days | 32 business days |
| Major non-conformance | 45 business days | 37 business days | 65 business days |
Preliminary review timeline
Once we receive your permit application, our team will conduct a preliminary review to confirm that all required documentation is included. Exact timelines are impacted by the volume and completeness of applications received.
Speed up the permit process with a complete application
Only 50% of development applications are complete and conforming when first submitted.
That means 50% of applications require revisions, leading to delays and extra work for both applicants and the development office.
Why it matters
Incomplete applications:
- Require back-and-forth communication
- Take more time and effort for applicants
- Increase the workload and slow down the processing of other permits
Speed up your application process
To avoid delays and help us serve you faster:
- Review your application carefully before submitting
- Ensure all required information and details are included
Book a pre-application meeting with a planner from Parks Canada or the Municipality of Jasper. These meetings are one of the best ways to set your application up for success.
Development office numbers
The following graphs provide information on permits issued since September 2024 following the wildfire. Data includes all projects in Jasper National Park including within the Municipality of Jasper and outside the townsite. Data also includes commercial and non-commercial properties.
Rebuild: Permits issued for the rebuild of properties that were severely impacted or destroyed by fire.
Recovery Related: Permits issued for recovery related projects, such interim housing and uses, fire-related repairs or replacements, and additional rebuild phases (garages, landscaping, phased construction, or multiple projects on a single property).
Other Projects: Permits issued for all other projects, such as renovations, new residential developments, and projects not related to the fire.

Text version
| Month | Rebuild | Recovery Related | Other projects |
|---|---|---|---|
| September 2024 | 0 | 6 | 3 |
| October 2024 | 0 | 9 | 9 |
| November 2024 | 0 | 12 | 11 |
| December 2024 | 0 | 18 | 17 |
| January 2025 | 0 | 24 | 25 |
| February 2025 | 8 | 28 | 34 |
| March 2025 | 16 | 36 | 38 |
| April 2025 | 23 | 44 | 42 |
| May 2025 | 41 | 51 | 54 |
| June 2025 | 59 | 57 | 70 |
| July 2025 | 79 | 65 | 81 |
| August 2025 | 100 | 75 | 87 |
| September 2025 | 116 | 83 | 100 |
| October 2025 | 132 | 92 | 111 |
| November 2025 | 139 | 94 | 122 |
| December 2025 | 153 | 95 | 127 |
| January 2026 | 164 | 99 | 131 |
| February 2026 | 174 | 101 | 134 |
| March 2026 | 179 | 109 | 145 |
| April 2026 | 197 | 126 | 165 |
| May 2026 | 215 | 138 | 185 |
| June 2026 | 215 | 138 | 188 |

Text version
| Month | Rebuild | Recovery Related | Other projects |
|---|---|---|---|
| Septembre 2024 | 0 | 0 | 2 |
| October 2024 | 0 | 0 | 4 |
| November 2024 | 0 | 0 | 4 |
| December 2024 | 0 | 0 | 9 |
| January 2025 | 0 | 3 | 11 |
| February 2025 | 0 | 7 | 16 |
| March 2025 | 3 | 9 | 18 |
| April 2025 | 4 | 12 | 21 |
| May 2025 | 10 | 16 | 22 |
| June 2025 | 15 | 17 | 26 |
| July 2025 | 32 | 18 | 30 |
| August 2025 | 48 | 19 | 35 |
| September 2025 | 66 | 20 | 39 |
| October 2025 | 88 | 29 | 44 |
| November 2025 | 108 | 34 | 48 |
| December 2025 | 116 | 44 | 51 |
| January 2026 | 117 | 48 | 52 |
| February 2026 | 125 | 50 | 53 |
| March 2026 | 134 | 69 | 54 |
| April 2026 | 152 | 76 | 56 |
| May 2026 | 164 | 84 | 63 |
| June 2026 | 167 | 85 | 65 |
